Archive

Archive for the ‘Project Server 2010’ Category

Hiding tasks from the Gantt Chart

January 21, 2013 1 comment

Have you ever wanted to hide tasks from the Gantt Chart? The following technique is useful for tidying up a schedule – for example, if you want to show only pertinent Gantt information for a presentation, or take a screenshot of a plan for a client that contains some internal tasks.

To hide individual bars in the Gantt display, simply insert the “Hide Bar” field and set it to “Yes” for the requisite tasks:


After hiding:


You’ll notice that all incoming dependencies for the hidden bar are also hidden, so take care when looking at your predecessor/successor logic!

Lester

Showing/hiding items from the Gantt Chart

January 10, 2013 1 comment

A useful little nugget about Microsoft Project that came in handy the other day is showing or hiding items from your Gantt chart. It’s as simple as this:

In Microsoft Project right-click in the Gantt Chart and select “Gridlines”:


To show, for example the Current Date on your Gantt, select “Current Date” and change the line type from blank to any other line style. Change the colour if required, then click “OK”.

My example here is showing the Status Date as a red line, and the Current Date as a blue line:


Traffic light indicators for schedule

January 2, 2013 3 comments

One query that we receive a lot from our clients is about setting up automatic traffic light (or RAG) indicators for their project schedule. This is a very well documented request, but a recent client wanted a slight variation – the project schedule indicator to have its tolerance based on a percentage, instead of a hard-coded value. The following formula solves this issue:



IIf([Baseline Duration]=0,"No Baseline",

Switch([Baseline Start]=ProjDateValue(‘NA’) Or [Baseline Finish]=ProjDateValue(‘NA’),"No baseline",

[Duration Variance]<=0,"On schedule",

[Duration]/[Minutes per day]>([Tolerance for schedule in percent]/100)+([Baseline Duration]/[Minutes Per Day]),"Outside tolerance",

[Duration]/[Minutes per day]<=([Tolerance for schedule in percent]/100)+([Baseline Duration]/[Minutes Per Day]),"Within tolerance"

))

This is for the task schedule RAG, and will return values based on a number field called “Tolerance for schedule in Percent” to indicate whether the task duration has increased beyond its allowed tolerance.

You will also need to set up RAG graphical indicators for this field as well, with the following values, as per the screenshot below:

No baseline = Question Mark

On schedule = Green

Within tolerance = Amber

Outside tolerance = Red

clip_image001

Of course, your indicators could be different to those that I have chosen, as well as the text. Just make sure to update the formula if you want to change the returned text.

Hopefully this will shorten your chin-scratching time when attempting to do something similar!

Lester

Using the “Inactivate Tasks” functionality

Inactivate task is a new feature for EPM2010; this feature enables the project manager to set certain tasks to inactive rather than deleting the tasks. This functionality is also useful for performing what-if analysis.

The following paragraph from Microsoft explains that intended usage of the inactivate task functionality:

“Microsoft Project Professional 2010 enables you to cancel a task but keep a record of the task in the project plan. This is called inactivating the task. The task remains in the project plan, but does not affect resource availability, the schedule or how other tasks are scheduled. Note: Inactivating a task is a feature available only with Project Professional.
Why would you want to inactivate a task? For one thing, it can help you model the effects of schedule or resource constraints on the project without deleting tasks permanently. Also, inactive tasks remain in the project plan, providing a record of cancelled tasks and enabling you to reactivate them if circumstances change.
Note: Inactivation is nor a good way to archive complete tasks, because it could have unanticipated effects on the remaining schedule. Instead, mark the tasks as completed.”
http://office.microsoft.com/en-us/project-help.inactivate-a-task-HA010370341.aspx

Please see the following best practise guidelines for using inactive tasks:

  • When in the planning phase, if you decide that a task or tasks are not required, at this stage use the inactivate task feature to set tasks to inactive rather than deleting the tasks. this will give you the option to quickly make these tasks active at a later date if there is a requirement for these tasks.
  • Inactive tasks do not affect resource availability. Baseline values that have already been taken are retained, but any new baselines taken will not include data for inactive tasks.
  • Tasks that have actual work cannot be made inactive.
  • Inactive tasks are not published, so inactive task assignments will not appear on a team member’s task list.
  • Inactive tasks are available to report on via the Project Server OLAP cube, so care should be taken when reporting that these tasks are/aren’t included depending on the figures required. The “Task is Active” field  can be used to include or exclude inactive tasks. If you do not see this field in your OLAP cube, it may be that the EPM administrator has not enabled inactive tasks in the cube.

Updating resource rates

Due to possible differences in calendars between EPM (Enterprise Calendars) and Microsoft Project (local project settings), resource rate changes using an effective from date may not be applied from the beginning of the working day. At one client in particular, where all resources in the Enterprise Resource Pool received an updated (increased) rate from the first of the financial year, this caused project financial information to be out by a couple of hundred to a few thousand pounds. Given that this particular client uses timesheet and therefore project actual work and cost figures to update their financial system for client billing, this is quite a big problem.
This article describes how to set the effective from time for the resource rate in order to ensure that it is applied from the beginning of the working day.

Setting Project Options

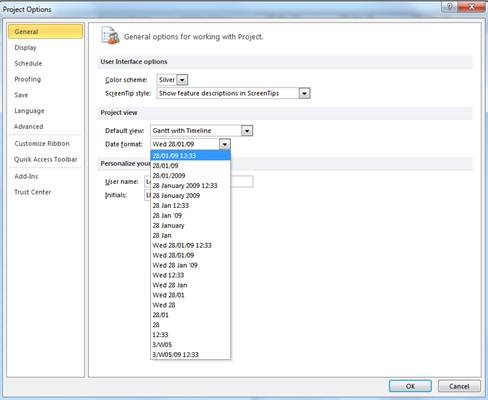

Open Microsoft Project and click on File > Options. Under the General tab, change the Date format to include the time, as below, and then click OK.

clip_image002

Updating resources
For resources that require a rate change, navigate to Resource Center in PWA. Select the resources for which the rates should be updated and click Open:

clip_image004

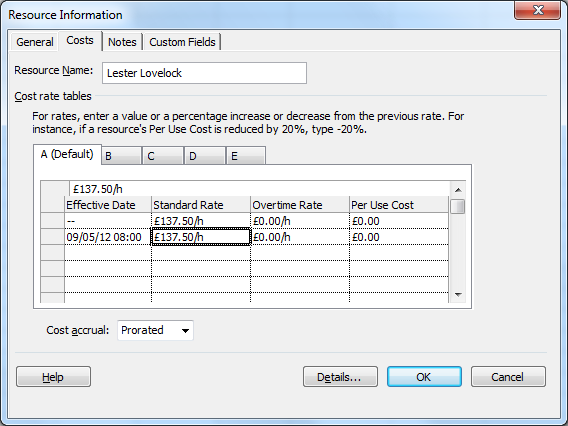

This will open the selected resources in Microsoft Project. To update the resource rate, double click on the resource and click on the Costs tab. The Effective Date will contain the time as well as the date. Ensure that the time is set to the same as the Enterprise Calendar for the start of the day.

clip_image005

Repeat for all resources as required. When complete, save the changes to enterprise resources (File > Save) and close  Microsoft Project.
If required, change the date display setting back to show only the date by repeating the steps above.

Issue Downloading SharePoint 2010 Prerequisite Installer Files

April 25, 2012 2 comments

Strictly speaking this quick article doesn’t really have anything to with SharePoint, but hopefully it might help-out someone out there in SharePoint land.

One of the projects I’m currently working on is a 2010 Farm build, we are just getting the media set ready to install SharePoint with AutoSPInstaller, and of course need to download the Pre-Requisite Installer Files. For this particular project I have no local access to the servers so everything is being done by RDP on the server. So to download the Pre-Requisite Installer Files I’m was using this script from codeplex, but it was failing with a really wierd error

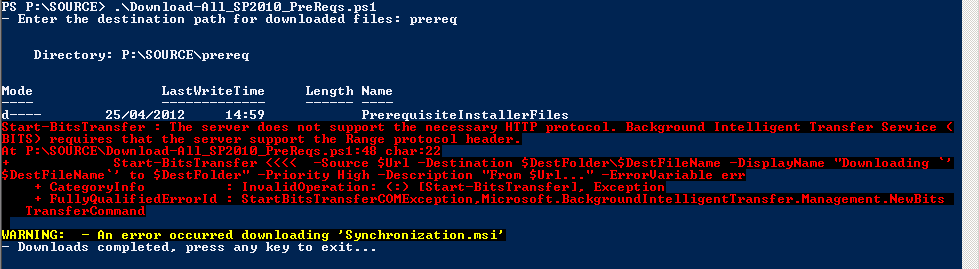

I tried it on a few different servers, but they all had the same problem.

I could of course simply open the script, grab the URL’s and paste them into a browser, but where is the fun in that.

This KB article talks about foreground / background transfers, and this being a problem when using background transfers and that foreground should be okay.

This article describes the cmdlet references for BITS and the –Priority switch that controls the foreground / background transfer setting

So the fix was to change this line

Start-BitsTransfer -Source $Url -Destination $DestFolder\$DestFileName -DisplayName "Downloading `’$DestFileName`’ to $DestFolder" -Priority High -Description "From $Url…" -ErrorVariable err

to this line

Start-BitsTransfer -Source $Url -Destination $DestFolder\$DestFileName -DisplayName "Downloading `’$DestFileName`’ to $DestFolder" -Priority Foreground -Description "From $Url…" -ErrorVariable err

and Voilá, pre-reqs downloaded . Smile

Project Server – "An unknown error has occurred"

April 17, 2012 1 comment

I recently had an issue at a client where the Project Center was failing to load and returning “An unknown error has occurred” on the page. We have seen this behaviour before and it’s usually some corrupt Project data that causes it, but I’ve never had the time to get to the bottom of the problem. Fortunately, today I had a bit more free time to investigate.

This particular issue is caused by custom fields that are linked single value (read: not multi-select) lookup tables erroneously getting multiple values assigned to them. How this occurs is as-yet unclear, but it appears to be symptomatic only in the published database – the draft and reporting databases are unaffected.

So, what’s the fix?

There are a couple of things that can be done, depending on your level of access and technical capability. Firstly, we need to identify the plans that are causing the issue. The fastest way of doing this is with a little piece of SQL code (change <Published_DB_name> to your actual Project Server published database name):

USE <Published_DB_name>
SELECT
(SELECT proj.PROJ_NAME FROM dbo.MSP_PROJECTS proj WHERE pcf.PROJ_UID = proj.PROJ_UID) as ProjectName
,(SELECT pcfv.[MD_PROP_NAME] FROM [dbo].[MSP_CUSTOM_FIELDS] pcfv WHERE pcfv.[MD_PROP_UID] = pcf.MD_PROP_UID) as CustomFieldName
,count(*)
FROM [dbo].[MSP_PROJ_CUSTOM_FIELD_VALUES] pcf
GROUP BY PROJ_UID, MD_PROP_UID
HAVING COUNT(*) > 1
ORBER BY ProjectName, CustomFieldName

(credit to Jan @ Piet Remen’s blog for the above query – http://pietremen.blogspot.co.uk/2012/01/project-centre-unknown-error-has.html)

This will return a list of projects, custom fields and the number of times that the custom field has been populated. If any project appears as an output of this script, you can view view the issue by taking a look at the Project Information through PWA. Affected custom fields will appear comma separated – e.g. Project Priority: Low, Low, Low, Low – where they should only appear as a single value.

The fix is quite a simple one – republish the project. This pushes the values from the draft database back to the published database and overwrites the broken custom field values. Check in PWA > Project Information, or re-run the above query to check that the plan is now fixed in the published database. I have seen a couple of instances where this did not fix the problem, and we had to delete the published version of the plan, and re-publish from the draft version.

It is still unclear how long the project will remain “fixed”, we have had a couple of plans reproduce the issue after being republished.

Microsoft have identified the issue, and released a fix, which can be found here: http://support.microsoft.com/kb/2598251

This KB is also included in the roll-up package (http://support.microsoft.com/kb/2597152) though it’s not documented.

These KB’s will prevent the issue occurring in the future, but will not fix existing problems – be sure to follow the above steps to ensure that the plans are fixed. As always – be sure you have database backups before applying updates!

SharePoint Patching and “Action Required”

March 27, 2012 1 comment

The last 2 SharePoint 2010 systems I have looked at have displayed the “Action Required” status for one or more servers in the farm in the “Manage Servers in this Farm” page, which is normally caused by incorrect server patching.

When you apply a Service Pack or CU to your SP2010 farm, you are normally looking at performing a quite straight forward 3 stage process.

Stage 1: Obtain patch:

Download the latest Service Pack or CU from here:

http://technet.microsoft.com/en-us/sharepoint/ff800847#LatestUpdates or use the “Use this page to view the latest patch status for products installed on servers in the farm” link on the CA site in Central Administration > Manage Patch Status




Stage 2: Install Patch

Once you have your Service Pack or CU, you will need to run it on each of the servers in your SharePoint Farm that has the SharePoint binaries installed, there is no special order to do this, but personally I like to run the patch on each WFE in turn, then on the application servers.

Once the patch has installed you will normally be prompted to run the Config wizard, if you are working on a single server farm, run the Config Wizard at this point, if you are working with a multi server farm cancel the Config Wizard and run the patch on each server on your farm.

Stage 3: Config Wizard

If you are running a single server system and have followed the instructions in stage 2, you should be finished. If you are running a multi-server farm you now need to run the Config Wizard to finalize the patch install. I like to run the wizard on the 1st server I patched and let it run to completion, then run the wizard on the rest of the servers in the farm, again there is no particular order to this but personally I like to run the wizard in the same order as I patched the servers, Once finished a quick reboot all round and we are done, and your status should be “No Action Required”


#ProjectServer 2010 / 2007 high-level Audit Export via #PowerShell #MSProject #PS2010 #EPM

March 9, 2012 1 comment

Quite often there is a request for audit information from Project Server but unfortunately there is nothing available out of the box. This post covers a very high-level solution to this using the Project Server PSI and PowerShell.

Most actions in Project Server are processed via the Project Server queue, one simple way to get high-level audit information is to extract the queue information. The following PowerShell script uses the ReadAllJobStatusSimple method from the Queue System web service to export yesterdays processed jobs into a txt file with yesterday date appended to the filename:

$Today = Get-Date
$Yesterday = $Today.AddDays(-1).ToString("yyyy-MM-d")
$Filename = "C:\PSAuditExport\QueueExport-"
$filetype = ".txt"
$svcPSProxy = New-WebServiceProxy -uri "http://vm353/pwa/_vti_bin/PSI/QueueSystem.asmx?wsdl&quot; -useDefaultCredential
$svcPSProxy.ReadAllJobStatusSimple("$Yesterday 00:00:01", "$Yesterday 23:59:59", "200", "0", "QueueCompletedTime" ,"Ascending").Status | Export-CSV $Filename$Yesterday$filetype -Delimiter "|"

For the full post please see:

http://pwmather.wordpress.com/2012/03/05/projectserver-2010-2007-high-level-audit-export-via-powershell-msproject-ps2010-epm/

#ProjectServer 2010 PSI data to a text file using #PowerShell #PS2010 #Project

July 15, 2011 Leave a comment

I recently looked into accessing the Project Server PSI via PowerShell, luckily I came across this MSDN article that helped: http://msdn.microsoft.com/en-us/library/gg607685.aspx#pj14_GettingStartedTa_PowerShell. I needed to get the data into a pipe delimited text file without using compiled code (I’m not a developer!). I have done this before with T-SQL and SSIS but I wanted to try something different. For the purpose of this blog article of have edited the example shown in the MSDN article. The PowerShell script is below:

$pwaUrl = "http://vm353/pwa"

$svcProjectUrl = $pwaUrl + "/_vti_bin/PSI/Project.asmx?wsdl"

$c = Get-Credential

$svcProjectProxy = New-WebServiceProxy -uri $svcProjectUrl -credential $c

$svcProjectProxy.ReadProjectList().Project | Select Proj_name, Proj_UID, Proj_Type `
    | Export-CSV C:\projects.txt -Delimiter "|"

This script will export out a list of Project names, Proj UIDs and the Project Types to the C drive in a text file called projects.txt using the pipe delimiter. Screen shots below show the script and the output.

Script:


Output:


This is a very simple example but provides a no code solution to access Project Server data via the PSI.
